Systems

How we work, and what it's built from.

Process

Five stages. One accountable team.

Design
01Design
Production
02Production
Delivery
03Delivery
Assembly
04Assembly
Handover
05Handover
Lead timeQuoted per project
Next open production slotAsk the factory →
Annual capacity18,000 m²
01Design

Architectural solution, structural statics, panel structure, thermal performance, acoustics, fire safety (REI30/60/90), moisture protection and building-services integration.

02Production

Sigulda factory, C24 Latvian timber, up to 1,500 m² produced per month on our own production line.

03Delivery

Packed to a loading plan with optimised cargo geometry for transport to Sweden, Norway and Switzerland. Roughly 40 to 50 m² of building area travels on one truck, auxiliary materials included, and every delivery is verifiable truck by truck.

04Assembly

Assembled on site by MasterIndustry's own crews, never subcontracted. Work happens under roof cover, protected from the weather, with elements sealed and blower-door airtightness tests completed.

05Handover and warranty

Airtightness tested (blower door) as standard, handed over with complete as-built documentation.

Our side

  • Architecture, in wood
  • Production in the factory
  • Transportation to the site
  • Montage on site
  • Outside ready, on site
  • Executive documentation, per the recipient country's rules

Your side

  • Securing the project
  • Local architects and permitting
  • Groundworks, foundation and external utilities
  • Crane and site equipment, where agreed
  • Inside-ready finishing works
  • Landscaping and on-site management
Scope of works

A worked example, line by line.

The scope form for Svartgarn. Every project gets its own.

1Design works
Traditional architectural and structural designTimber structure design
2Groundworks
Earthworks and excavationExternal utilities: water, sewerage, electricityFoundation construction
3.1Building frame
Structural frame productionTransportAssembly and on-site installation
3.2Building envelope
Roofingnot in scopeWindow installationFaçade worksExternal doorsBalcony constructionnot in scope
4Internal utility systems
Electrical installationsPlumbing and sewer systemsHeating systemsVentilation and heat recoveryLow-voltage networks
5Internal finishes
Sanitary units and tilingInterior doorsStaircase installationFlooring worksPainting and wall finishesKitchen installation and fitted equipment
6External infrastructure
Road constructionPedestrian pathwaysChildren's playgroundsLandscaping
MasterIndustry scopeClient or general contractorExcluded from this offer
DIN EN ISO 6946High energy-efficiency buildingsLCA, life-cycle assessmentAirtightness test EN ISO 9972

Source: Form MI_1, Scope of Construction Activities, Rev. 1, 15 May 2026. Scope is set per project.

Illustrative render: a timber house exploded into foundation, floor, wall and roof elementsIllustrative render
Anatomy

A building as a kit of elements.

Wall, floor and roof panels are assembled in the factory, numbered and packed for sequenced assembly on site.

01

Panels

Prefabricated wall, floor and roof panels, built to a fixed build-up and delivered ready to erect.

02

Glulam and CLT

GL24h glulam and cross-laminated panels where the design needs long spans or stiff diaphragms.

03

Numbered for site

Every element is numbered and packed to a loading plan, then lifted into sequence by our crews.

Structures

The structural systems behind every building.

01

Wood panel structure

Prefabricated wall, floor and roof panels, factory-assembled to a fixed build-up and delivered ready to erect.

Prefab
02

Glue-laminated beams

Structural glulam, GL24h grade, for long spans and exposed frame structures.

Glulam
03

Cross-laminated timber

CLT panels for floors, walls and roof diaphragms that need high dimensional stability. Floor panels run to 220 mm.

CLT
04

Plywood sheets

Plywood sheets combined with the panel, glulam and CLT structure, on a monolithic concrete foundation with elevator shafts.

Plywood

Two systems, taken apart.

Wood panel and cross-laminated timber, shown layer by layer.

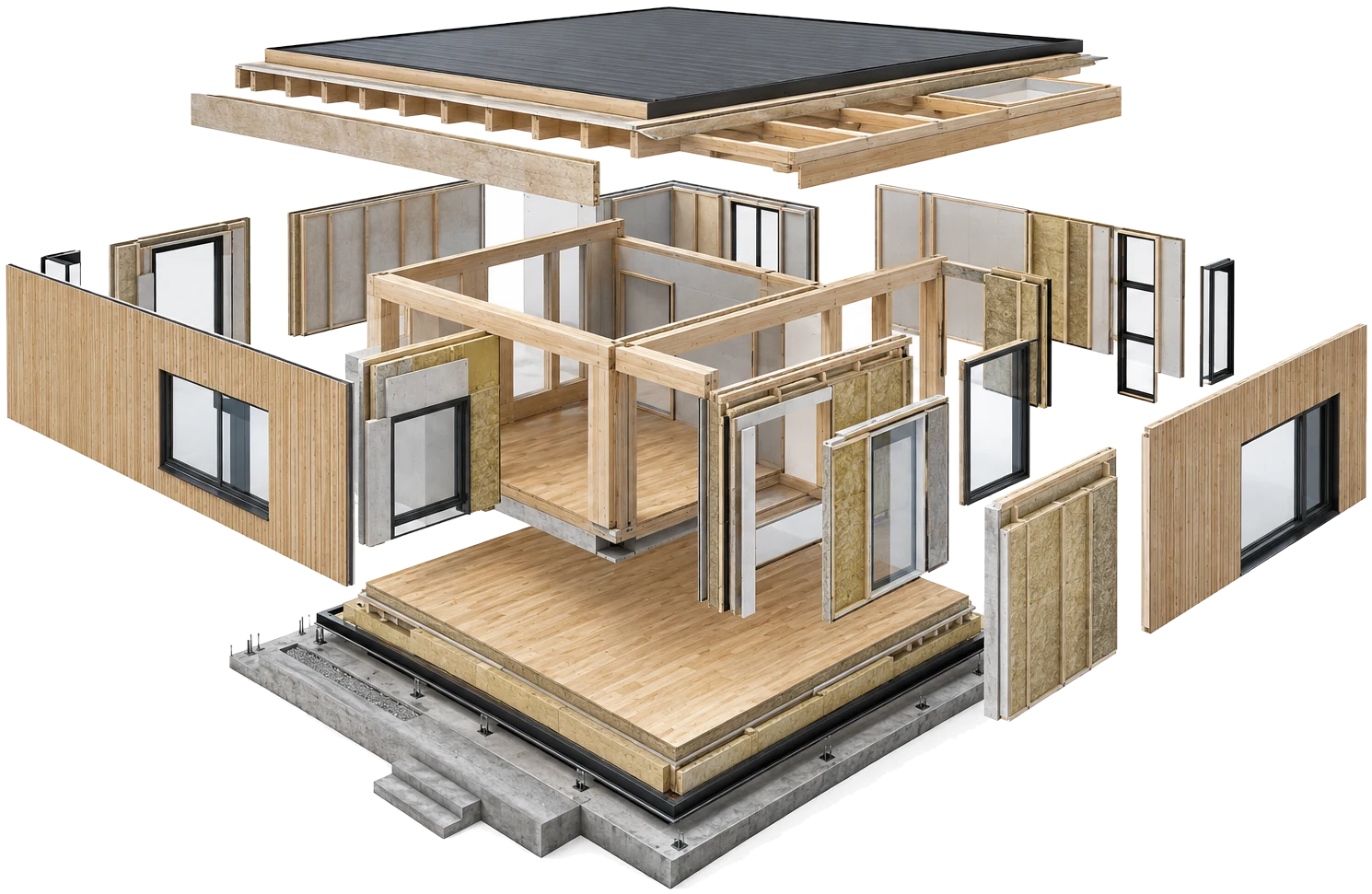

Illustrative render: Wood panel structure, exploded
Wood panel structure, exploded

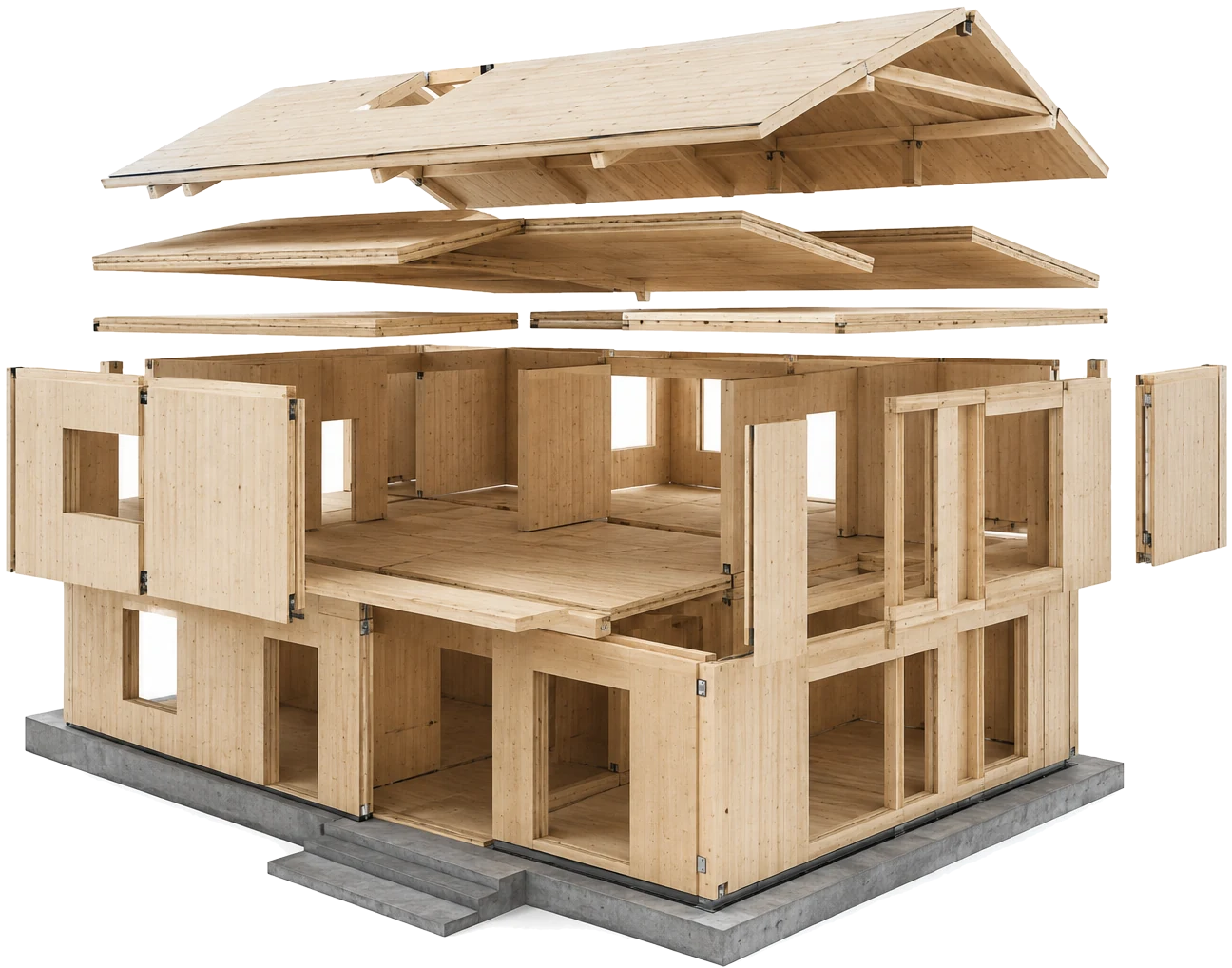

Illustrative render: Cross-laminated timber structure, exploded
Cross-laminated timber structure, exploded
01

Carbon storage

Sequesters carbon for the structure's lifespan instead of releasing it in production.

02

Strength-to-weight

Timber is light for its strength, which keeps the building light and foundation loads down.

03

Off-site speed

Panels are produced in a controlled factory while site works proceed in parallel.

04

Thermal performance

Insulated panel build-ups are engineered per project using Ubakus hygrothermal modelling.

05

Acoustic comfort

Layered assemblies are specified to meet party-wall and floor acoustic requirements.

06

Fire design

Fire ratings of REI30, REI60 or REI90 are engineered to the specific building.

07

Moisture management

Vapour barrier and breather membrane layers are specified, then tested before handover.

08

Design flexibility

Panel systems adapt from single modular units to multi-apartment developments.

Panel depths at a glance.

Bar length shows relative panel depth

  1. 245/45Exterior wall
  2. +350Roof covering panel
  3. 220Floor panel, cross-laminated timber
  4. 145/145Internal fire wall between apartments
  5. 95Internal wall, regular
  6. 145Internal load-bearing wall
  7. 195Internal load-bearing wall

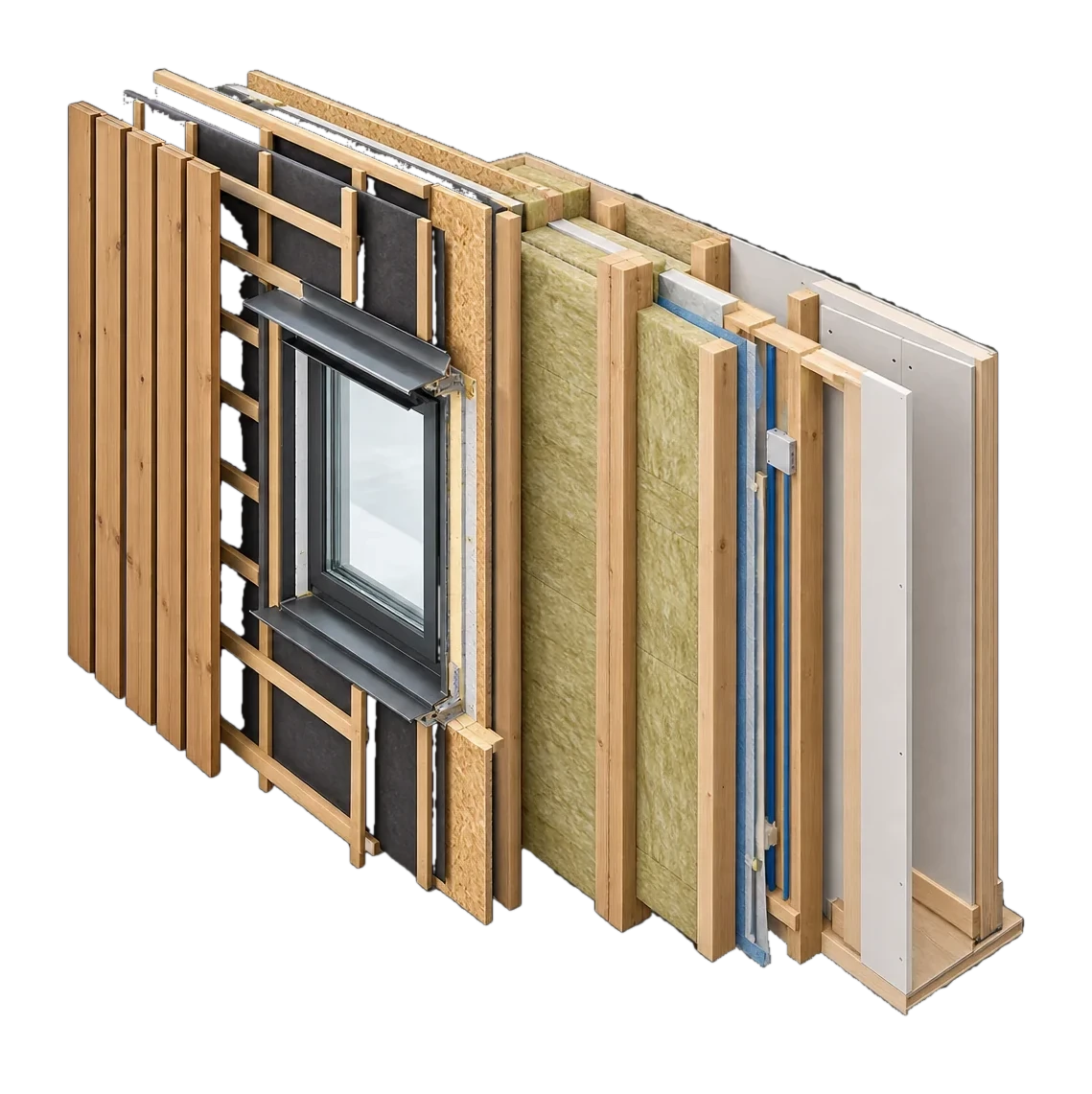

Illustrative render: timber wall build-up from cladding to plasterboard, with window opening
Illustrative render · framed wall panel

How a framed wall panel is made

  1. 01FrameC24 studs and plates, cut to the list that comes straight from the structural model.
  2. 02InsulationFitted between the studs in the factory, so the thermal layer is closed before the panel leaves.
  3. 03SheathingOSB fixed to the frame braces the panel and carries the racking loads.
  4. 04MembranesA vapour barrier on the warm side controls moisture and supports airtightness; a breather membrane outside lets the wall dry.
  5. 05OpeningsWindow and door openings are framed and reinforced in the panel, ready for installation.
  6. 06Numbered for siteEach panel carries its element number and is packed to the loading plan, then set in sequence by our crews.
Assemblies

Eight build-ups, layer by layer.

Calculated values from our assembly sheets. Choose an assembly to see every layer and its thermal data.

Wall · E195HD

Exterior wall

00/ 09layers set
InteriorExterior12345451956782592132.1 cm123454519567825932.1 cm

Schematic section. Thickness to scale, length not to scale.

U-value0.16W/(m²K)
00.24 limit0.40

33% below the 0.24 reference limit for existing buildings printed on the sheet (GEG 2020/24).

32.1cmTotal thickness
47kg/m²Weight
8.1hPhase shift
13Temperature amplitude damping
28kJ/m²KThermal capacity, inside
45kJ/m²KHeat capacity

Calculation conditions

  • Inside air 20 °C / 50 %
  • Outside air -5 °C / 80 %
  • Surface temperature: 18.8 °C inside · -4.8 °C outside

Used on Svartgarn.

All eight at a glance.

U-value in W/(m²K). Lower is better.

  1. AssemblyU-valueThicknessWeight
  2. Exterior wallE195HD0.1632.1 cm47 kg/m²
  3. Party wall145+1450.1339.4 cm68 kg/m²
  4. Load-bearing wall1450.2519.4 cm41 kg/m²
  5. Interior wall950.3514.4 cm38 kg/m²
  6. Intermediate floor2450.1536.1 cm62 kg/m²
  7. Upper floor ceilingA400RJ0.1145.8 cm49 kg/m²
  8. Insulated balconyCeiling0.1454.4 cm66 kg/m²
  9. Rafter roofRoof construction2.6839.0 cm88 kg/m²

Values are calculated, not measured, and are taken from each assembly sheet. Wall, ceiling and balcony sheets use inside air at 20 °C and 50 % humidity; rooms between two heated spaces carry no thermal requirement on the sheet. Full assembly sheets are issued on request.

Request the assembly sheets
On site

From foundation to roof, in sequence.

Our crews set elements under roof cover. Each step below is an illustrative render.

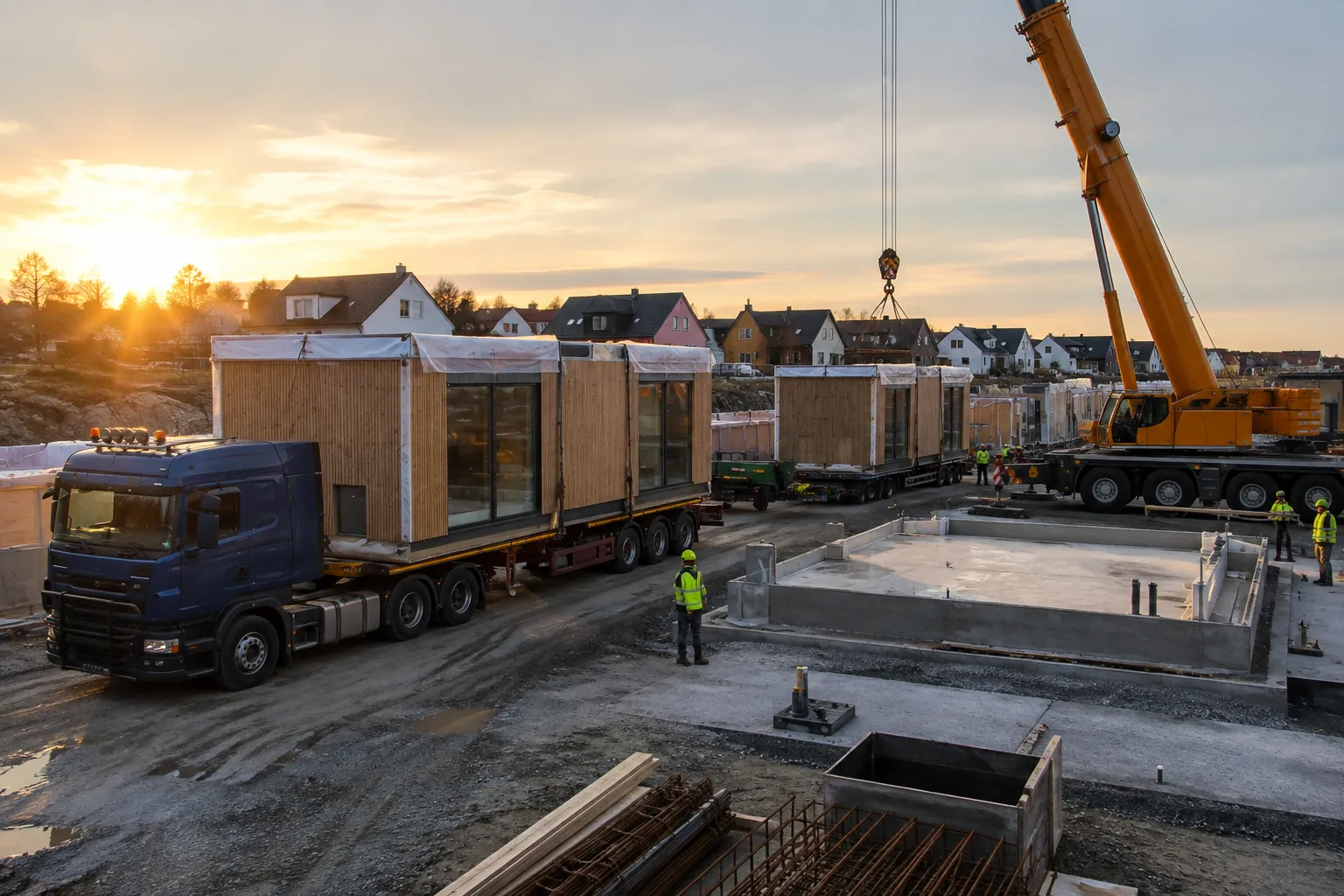

Illustrative render: Delivery to site
01 Delivery to site

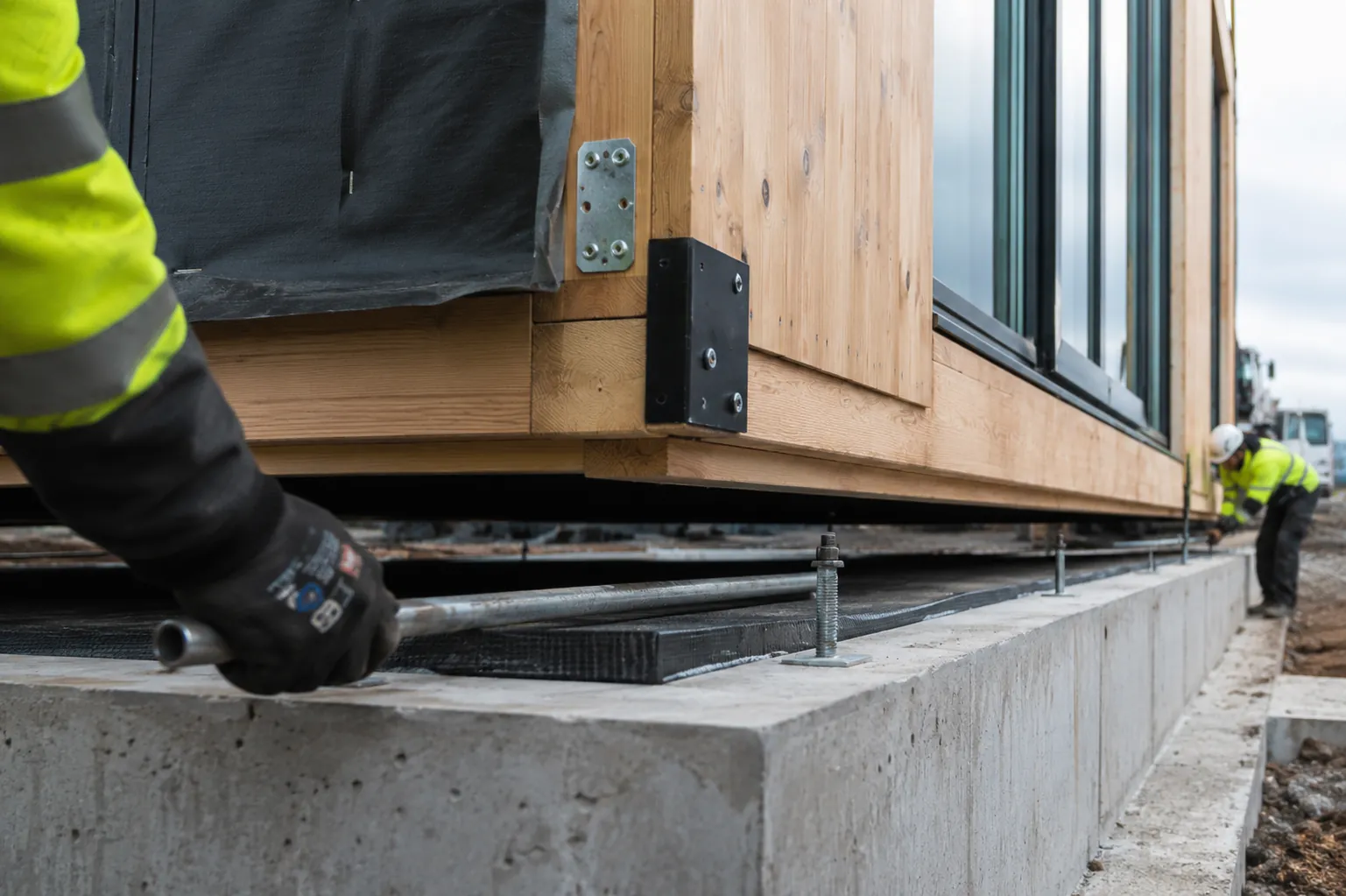

Illustrative render: Floor elements set
02 Floor elements set

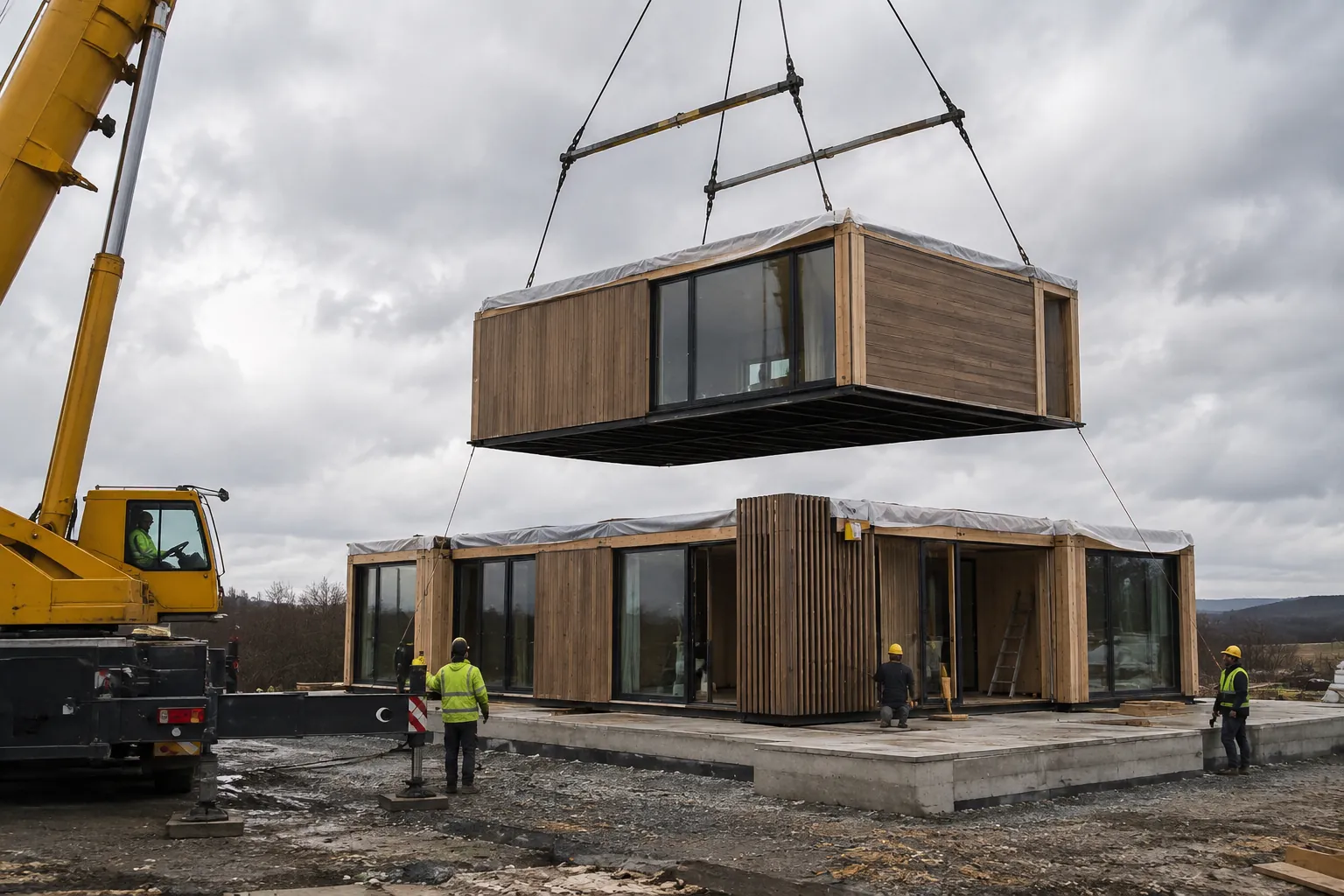

Illustrative render: Module lifted by crane
03 Module lifted by crane

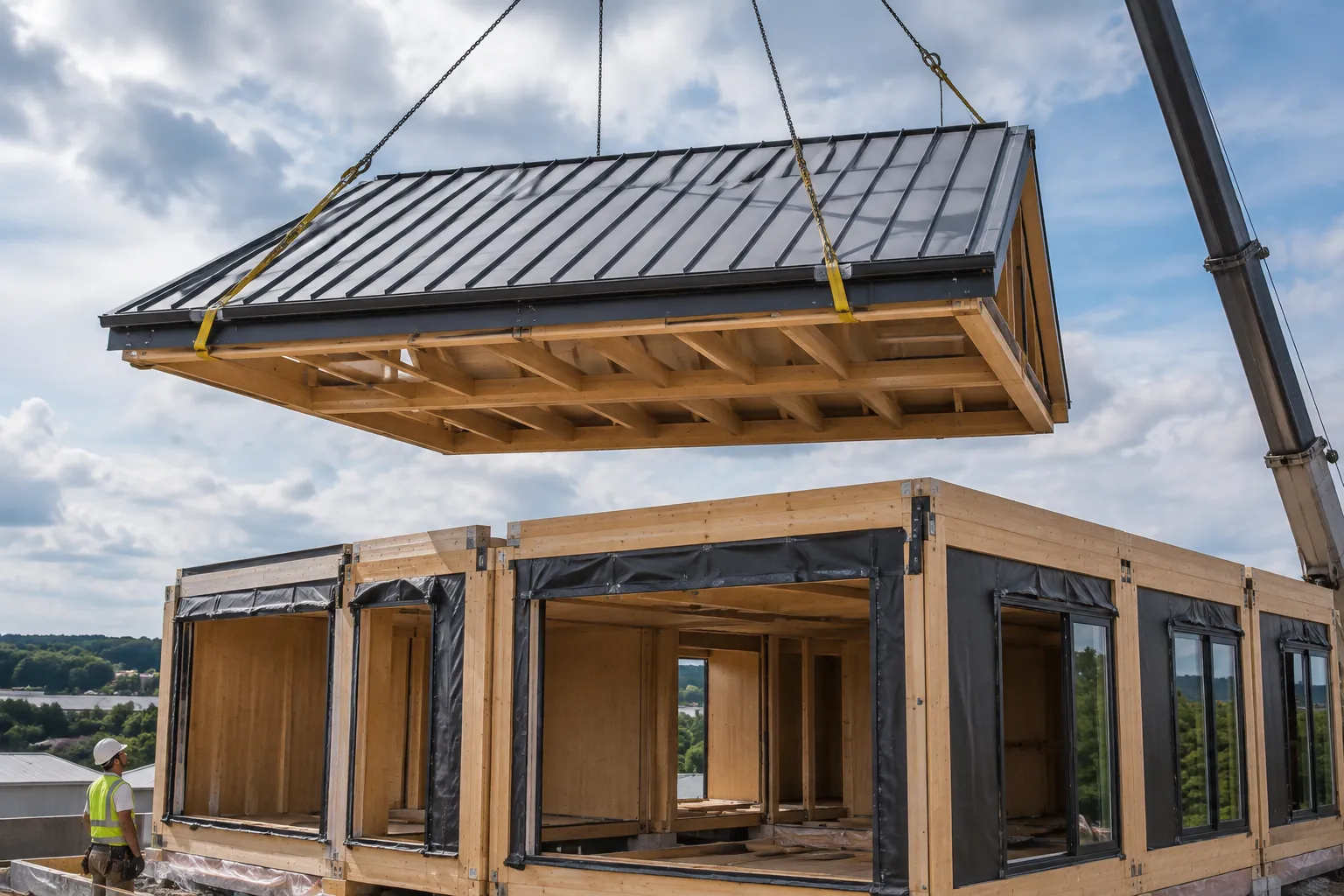

Illustrative render: Roof element lifted
04 Roof element lifted

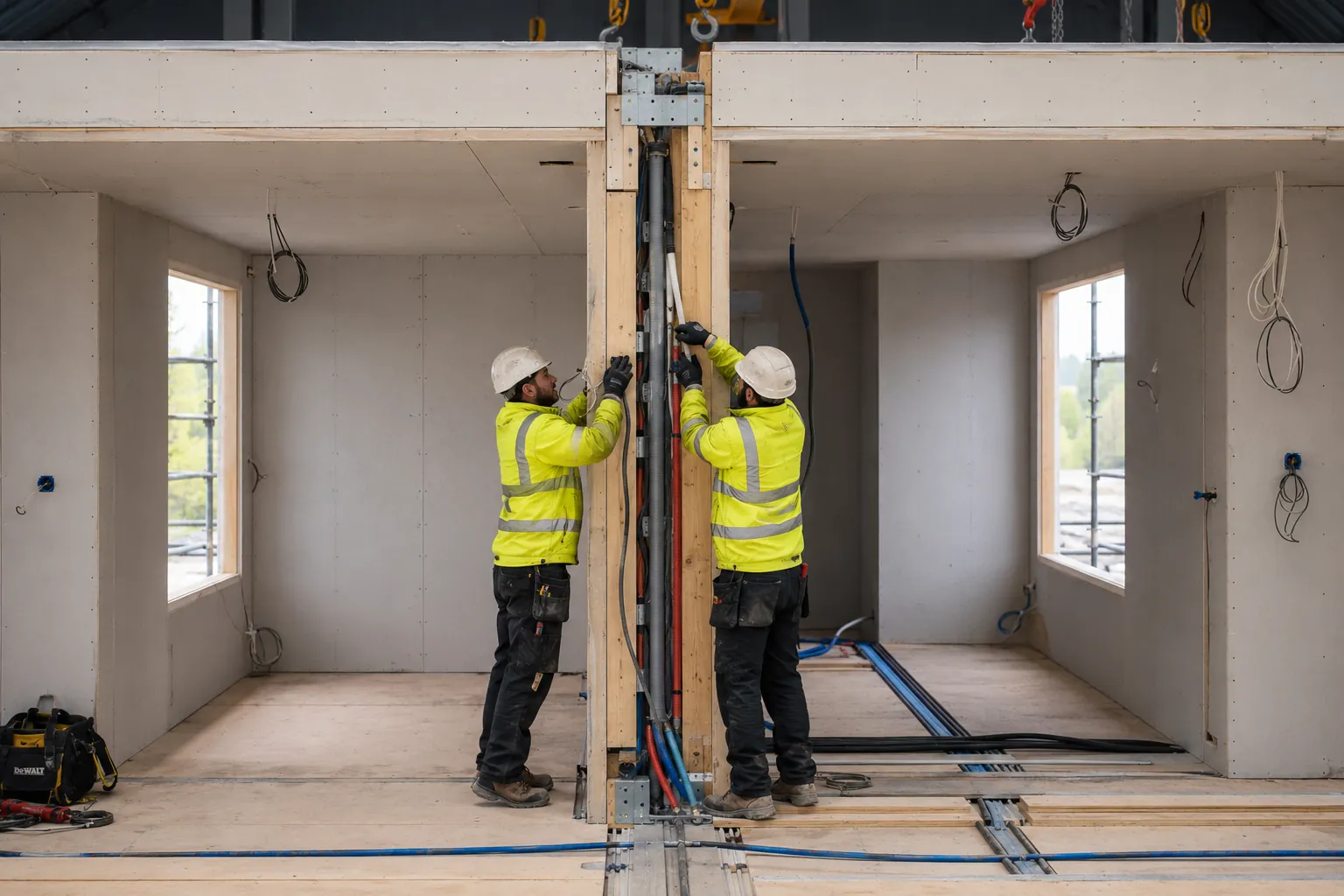

Illustrative render: Services integrated in the panels
05 Services integrated in the panels
Illustrative render: Façade finished, ready for handover
06 Façade finished, ready for handover
Engineering

The stack behind every calculation.

01

LCA

Life-cycle assessment per project to quantify embodied and operational impact.

02

EPD

Environmental Product Declarations in progress for core panel systems. See the certification roadmap.

03

SEMA

Production-engineering software that turns structural design directly into factory cutting lists.

04

Ubakus

Hygrothermal modelling for U-values and condensation risk in every wall build-up.

05

Passivhaus

Passive House methodology available on request for qualifying projects.

06

CO2-Zero

A carbon-reduction strategy across material sourcing and production. Target dates are on the roadmap.

Full engineering reports (Ubakus outputs, LCA data, SEMA production files) are issued on request.

Request the engineering pack
Documents

Documents, not renders.

System drawings

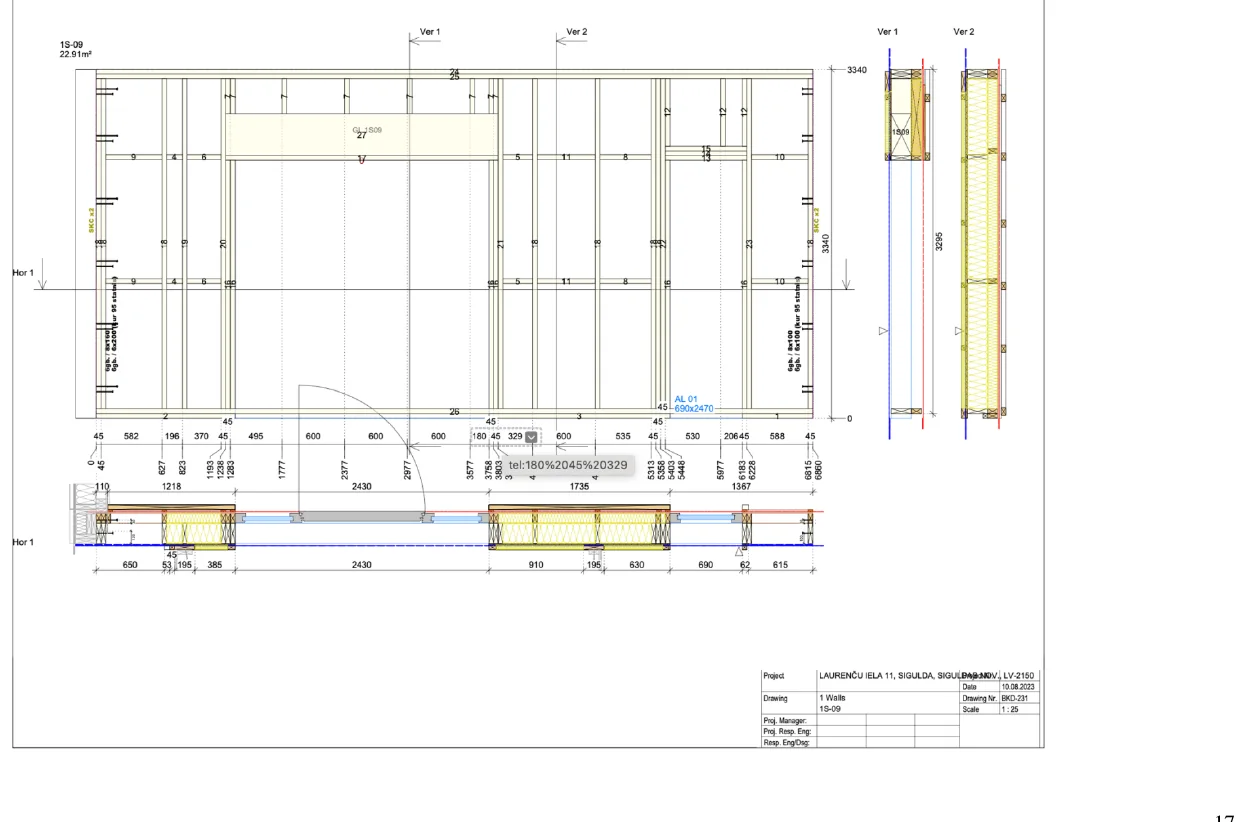

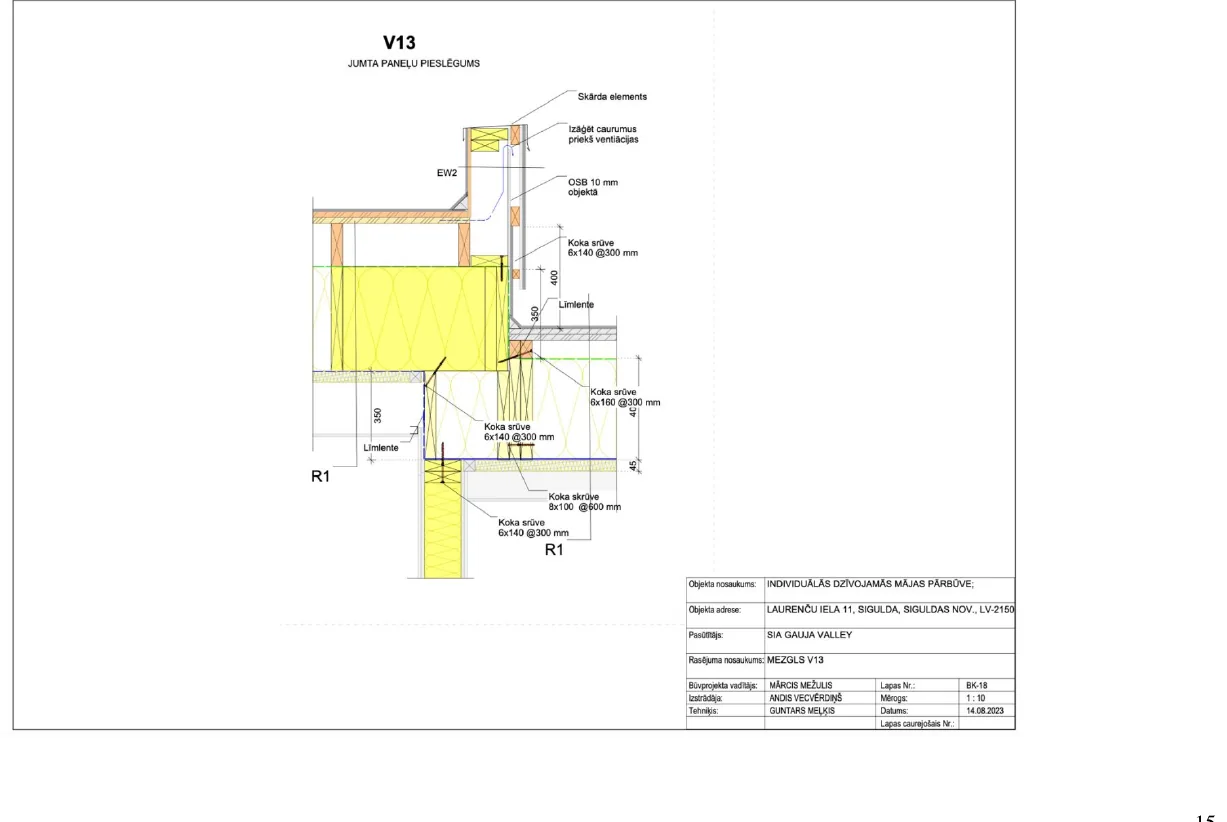

01System drawingsCoordination sets with wall, ceiling and roof panel layouts, sections, window and door details and 3D projection.
Production drawings
02Production drawingsPanel-level manufacturing drawings, with transportation and loading drawings, for the factory.

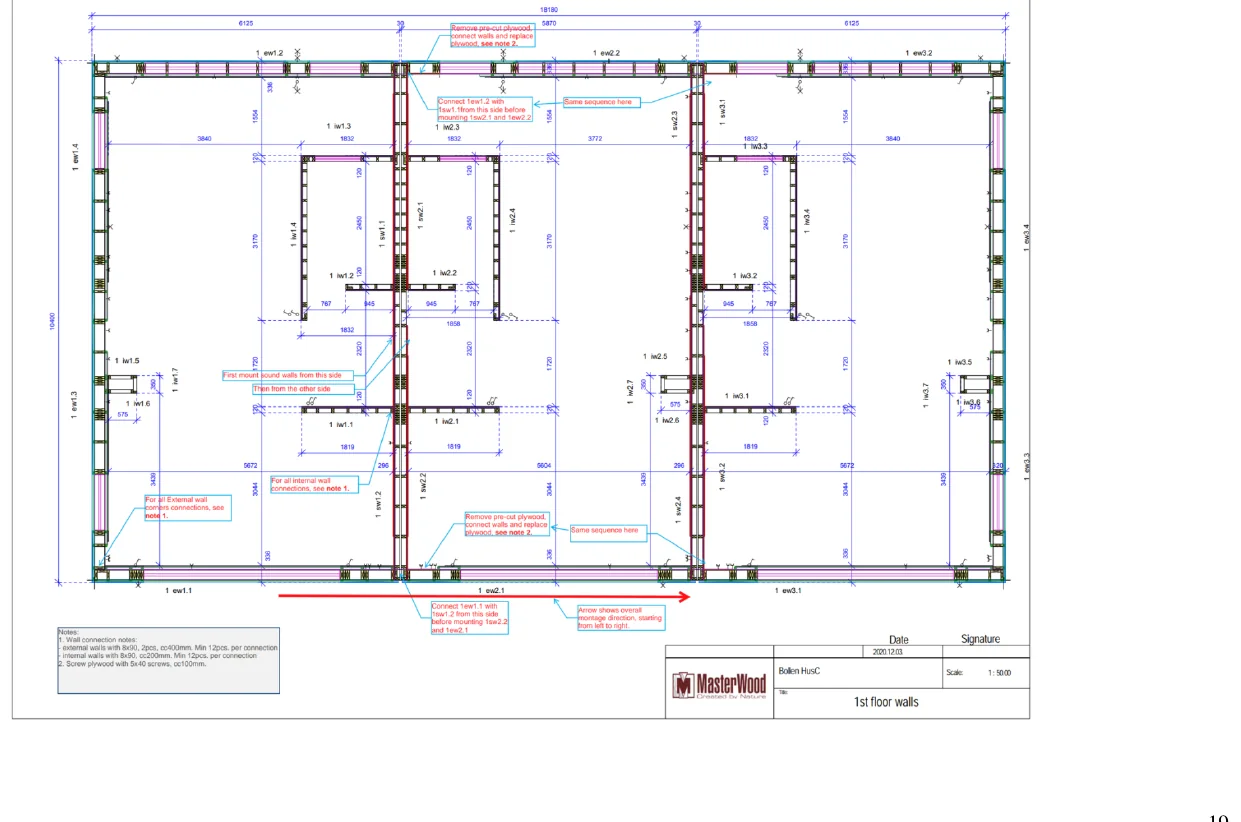

Assembly drawings
03Assembly drawingsMontage drawings for the crew on site, element by element.

Optional on request: CO2-zero calculation, energy certification and LCA. Full drawing sets are issued per project.

Ask for a sample set
Start a project

Tell us what you're building and where.

We reply with a realistic lead time, not a sales call.

Your details are used only to reply to this enquiry.
